AP Invoices
Visual Mapping
Demonstration
Configuration & FAQs
What are Billing Periods and how do I add them?
You may receive an error like the following: [Procore Error] The project must have an open billing period (or admin can specify a period_id) to create an invoice
when attempting to import AP or AR Invoices to Procore.
To fix this error, you will need to create a "Billing Period" in the Project. For context, a Billing Period defines the billing cycle used by a project's team and invoice contacts on Procore's invoices and progress billings. In addition to defining the frequency of the billing cycle (for example, monthly or weekly), a billing period also defines the billing cycle's start/end date and the due date for the invoice or progress billing.
To learn more about adding Billing Periods to Procore, see Procore's guides on creating manual billing periods and automatic billing periods.
Note, we recommend creating these Billing Periods in your Project Template(s), so you do not need to add Billing Periods for each Project going forward.
Error: Missing Contract
This error occurs when the Subcontract or Purchase Order associated with the AP Invoice has not been synced to Procore.
To resolve this error, sync the Subcontract or Purchase Order associated with this AP Invoice.
If you do not plan to sync the AP Invoice or related Subcontract or Purchase Order, you can Ignore the AP Invoice record.

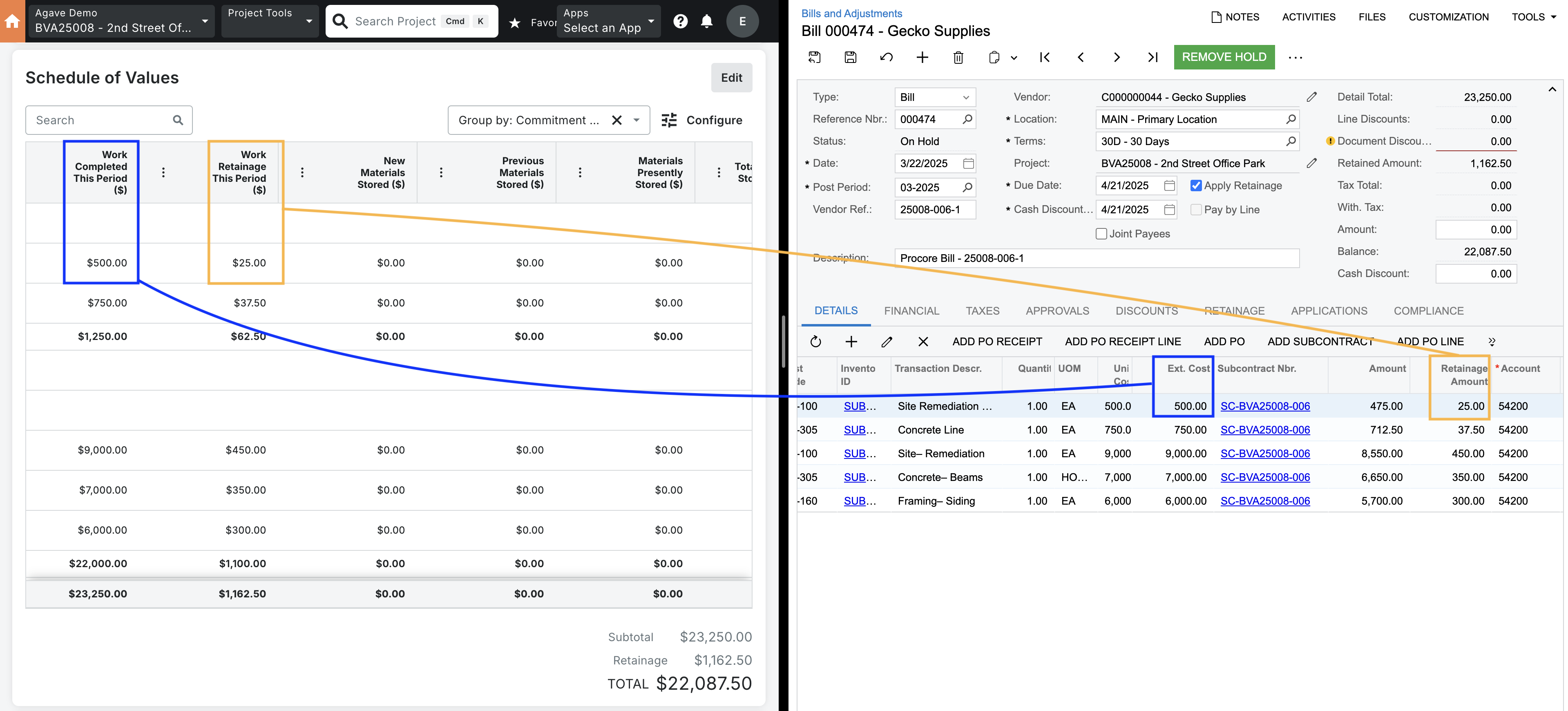

How are the subtotal and retention amounts calculated for each Line Item?
Subtotal Amount
Agave Sync calculates the subtotal for a Procore Subcontractor Invoice Line Item using this formula:
subtotal = total_completed_and_stored_to_date - total_completed_and_stored_to_date_from_previous
What this means:
total_completed_and_stored_to_date
is the cumulative value of work and materials completed and stored up to the current period.total_completed_and_stored_to_date_from_previous
is the cumulative value from the previous billing period.
The subtotal is the new work and materials completed/stored during the current period only (the difference between the current total and the previous total).
Retention Amount
Agave Sync calculates the retention amount for a Procore Subcontractor Invoice Line Item as:
retention = work_completed_retainage_retained_this_period + materials_stored_retainage_currently_retained + materials_retainage_retained_moved - materials_stored_retainage_previous_progress
What this means:
work_completed_retainage_retained_this_period
: the amount of retainage held from work completed in this billing period.materials_stored_retainage_currently_retained
: retainage held on materials currently stored (this period).materials_retainage_retained_moved
: retainage moved (for example, when stored materials are installed and the retainage category shifts).materials_stored_retainage_previous_progress
: retainage that was already reported in prior periods for stored materials (this is subtracted to avoid duplication).
This formula adds up all new retention for work and materials this period (including adjustments if materials have been moved into work-in-place) and subtracts any retention that’s already been accounted for in prior periods to ensure accuracy.
Materials Stored & Retainage
Though not pictured in the visual mapping, Agave does support syncing AP Invoices that use Materials Stored and Materials Retainage.
Status
By default, Agave syncs AP Invoices into Acumatica with the On Hold status. If you prefer a different status, work with your Agave rep to have it configured.
Negative Invoices
If the AP Invoice in Procore has a negative total amount, Agave will sync it to Acumatica as a Debit Adjustment.
